Gabon: Boulevard de la Transition, le chantier des comptes
Libreville, Wednesday, August 26, 2026 – The Boulevard de la Transition project in Libreville is currently progressing on two distinct yet interconnected fronts. On one hand, construction teams are pushing to accelerate work, aiming to overcome delays and open initial sections of the road. Simultaneously, within state offices, a more delicate and urgent task has begun: meticulously tracking public funds allocated to the project.
Recent investigations, highlighted in a report published on August 23, revealed significant discrepancies in the project’s financial trajectory. The initial contract value of 8 billion CFA francs reportedly escalated to 16 billion CFA francs. Furthermore, approximately 3 billion CFA francs were allegedly disbursed to a foreign operator identified as Goran. While these allegations await formal confirmation from judicial authorities, they have placed this pivotal infrastructure project at the heart of serious questions regarding the management of public procurement.
The sensitivity surrounding this issue is heightened by the fact that the Boulevard de la Transition is a cornerstone of Libreville’s urban modernization strategy. Spanning roughly three kilometers, it is designed to alleviate traffic congestion in the capital and forms part of a larger initiative that includes the future Administrative City. The project had already been designated a top governmental priority for the year 2026.
Initially envisioned as a symbol of urban renewal, the project now faces fundamental scrutiny, challenging a government committed to a new era of financial accountability. Critical questions arise: How could a public contract’s value double? What procedures permitted the disbursements that are now under dispute?
A financial investigation now in judicial hands
Information gathered from sources within the Taskforce responsible for monitoring, auditing, and verifying state participations and debt indicates that about 3 billion CFA francs were reportedly paid to the operator Goran without the necessary prior bank guarantee. The individual was subsequently questioned at the B2 intelligence service and, according to reports, admitted to “grave errors” before departing Gabonese territory. The same sources confirm that the entire file has been forwarded to the public prosecutor.
Such serious accusations mandate absolute caution. At this juncture, publicly available information does not definitively establish that an offense has been committed, nor does it assign criminal responsibility to any specific individual. It is precisely the mandate of the judicial inquiry to ascertain the nature of financial flows, the legitimacy of contractual procedures, potential liabilities, and the circumstances surrounding the operator’s departure.
Nevertheless, a significant institutional question persists. If the absence of a prior bank guarantee is indeed confirmed, why was this crucial condition not enforced before the disbursement? If the project’s cost truly doubled, what contractual amendments, administrative approvals, and economic justifications explain such a substantial increase?
These inquiries extend beyond the specific case of Goran. They delve into the core mechanisms of public procurement, a domain where administrative decisions, private enterprises, public funding, and economic interests converge.
Construction progress must not overshadow financial accountability

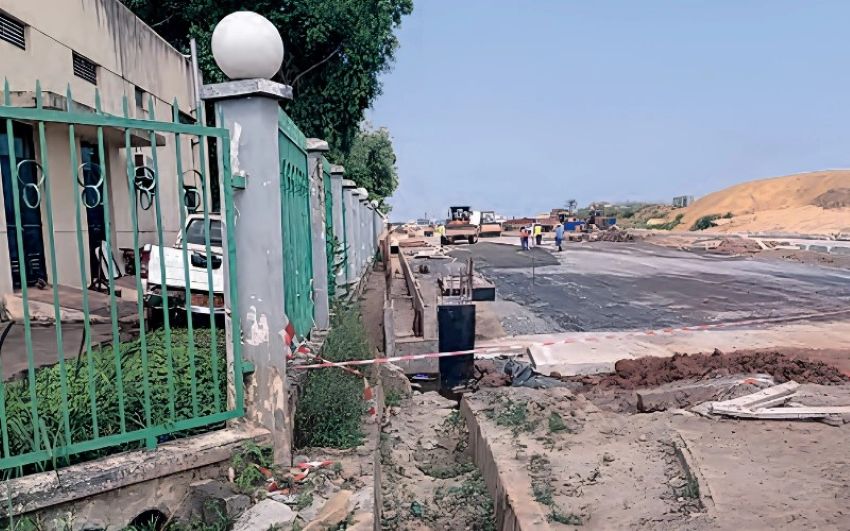

In parallel with the financial investigation, the Taskforce has reportedly intensified its oversight of the construction site. A report dated August 22, reviewed by our team, specifically calls for the rapid procurement of materials, an increase in equipment resources, and the resumption of night work. During a meeting on August 20, a presidential directive set the ambitious target of bringing the section between PK0+240 and PK0+800 to the impregnation phase by September 1st.
This accelerated pace of construction aligns with the project’s urban importance. However, it also raises critical governance concerns. While the state legitimately seeks to swiftly complete infrastructure that residents eagerly anticipate, it must equally safeguard evidence, meticulously document contracts, and establish any potential responsibilities when audits uncover irregularities.
This creates a paradox for the Boulevard de la Transition. As the physical construction becomes more visible, the demand for financial transparency must intensify. The public expects not only to see the road progress but also to understand the project’s true cost, the reasons behind that cost, and the rules governing contract awards and execution.
This imperative is particularly strong given the government’s past experiences with the financial and social repercussions of major urban development initiatives. In 2025, the Council of Ministers approved a waste management plan specifically for demolition debris linked to Libreville’s modernization and the Boulevard de la Transition works. Additionally, the project for relocating affected populations received support from the BDEAC.
Therefore, this dossier demands attention on two parallel and inseparable fronts: the effective delivery of the infrastructure and the financial integrity of the contract. The success of one cannot compensate for the failure of the other.
The Boulevard de la Transition must not merely symbolize a construction site measured by kilometers of road laid. It must also serve as an opportunity to demonstrate that public investment can be rigorously controlled from its inception to the final franc spent. If the alleged anomalies are confirmed, accountability must be established, and any damages rectified. Conversely, if they are disproven, the judicial system must clearly state that as well. In either scenario, the true work of the Transition aligns with the long-standing demands of citizens: making public funds traceable, justifiable, and verifiable expenditures.
